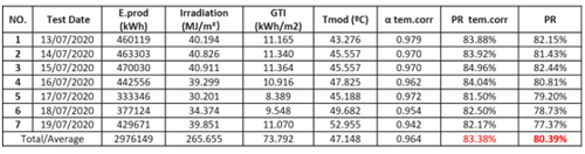

Onsite tests were performed according to IEC 61724: Photovoltaic System Performance Monitoring. The test result is as follows:
As shown, the all-time highest actual PR was 82.44%, and the seven-day weighted average was 80.39%. According to the PV system report submitted to the supervisor for review, the simulated PR for July was 76.6%. The actual PR is 3.8% higher than simulated.
How did this PV plant exceed expectations so dramatically? The project uses Risen Energy 330 W polycrystalline PV modules, Huawei SUN2000-185KTL string inverters, and Arctech Solar Skyline 1V84 trackers. The string inverters work with the trackers, and the PV modules move by tracking the sun, ensuring the optimal status of each PV string in the plant. The project owner said Huawei's string inverters provided outstanding performance in ensuring the efficient and reliable operation of the plant.
Huawei inverter's multi-MPPT feature can help minimize the impact of PV string mismatch during dusty and cloudy weather. A 3.5 MW PV array supports 170 MPPT routes to ensure that each PV string works at its optimum, which in turn brings higher energy yields. Not only this, but Huawei SUN2000 series string inverters can operate over a wide temperature range, which is befitting to environments with both extremes of hot and cold such as Kazakhstan. They can run stably in the temperature range of –40°C to 60°C, with the availability reaching over 99.996%. Extremely hot or cold conditions would usually pose severe challenges on components. Huawei employs high component selection standards and patented heat dissipation technologies to ensure the reliability of all components, even in difficult or severe environments.
In addition, Huawei string inverters use low power consumption control technology, power supply technology with a wide input voltage range, and power component shutdown peak suppression technology. They also support an operating voltage range as wide as 500–1500 V. A lower operating voltage lower limit enables inverters to start early and shut down late every day, which allows them to generate more electricity.
The success of this project is inseparable from the meticulous design and optimization of Risen Energy’s Overseas Project Technical Team based in China. Jeff Lv, Technical Director, was on site personally for inspection and research. Under his guidance, the technical team of Risen Energy compares more than 100 system design solutions with automatic configuration and loss algorithms, and analyzes the cost and benefit sensitivity. The team optimizes and selects the cost structure of each project. The modular, powerful, and capable solution design ensures a balance in project cost and quality. The corresponding balance created between cost and energy yield is the key to the high energy yield of the project.
According to data from the Ministry of Energy of Kazakhstan, in the first quarter of 2020, the country generated 548.4 million kWh of electricity using renewable energy, 35.7% of it generated from PV. In the Concept of Transition towards Green Economy, the Kazakhstan government proposed to increase the proportion of electricity generated from renewable energy to 3% by 2020. We believe that more PV plants with unexpected PR will make the future of Kazakhstan's PV market landscape brighter.
