The Dogger Bank offshore wind farm will provide clean energy to 6 million British homes yearly. Each of the three phases of the project will have an installed generating capacity of 1.2 GW, combined for a total of 3.6 GW, which will be capable of supplying 5 percent of the UK's electricity demand.
The wind farm, which will be the largest in the world, will have an innovative operations and maintenance centre on Tyneside. More than 40 long term jobs have been created locally to support operations and maintenance for the 35-year life of the wind farm.
Just one turn of the blade of each generator will produce enough energy to power an average UK household for two full days. The windfarm will feature 277 of some of the world's most powerful turbines, which at 260 metres high are almost twice as tall as the London Eye.
The wind farm will generate clean energy for 6 million homes once completed and fully operational. The project is being developed in three phases, Dogger Bank A, B and C, located between 130 kilometres and 190 kilometres off the north-east coast of England. Each of these phases will have an installed generating capacity of 1.2 GW and has involved an investment of billions of pounds. Combined, they will have an installed capacity of 3.6 GW.

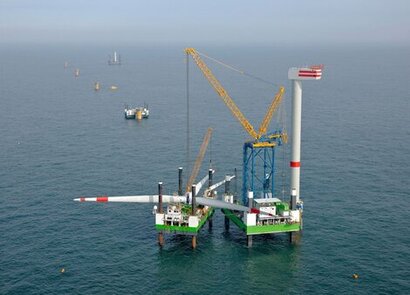

Sarens engineers have been entrusted with the lifting of the stackable modules, for which they selected an equipment of 2 crawler crane units with a lifting capacity of 600 tons, another crawler crane unit of 250 tons and a last crawler crane unit with a lifting capacity of 150 tons. These units are complemented by a 50T mobile crane, a forklift and a cherry picker. This equipment will remain on site for approximately one year, after its arrival in June 2023 and is expected to perform various heavy lifting tasks until at least June 2024.
In order to carry out the project as safely and efficiently as possible, Sarens team will perform the necessary calculations providing all relevant forecasting, and the engineering for each lift will be presented to the client prior to execution for review and possible modification. Although this kind of operation may slow down the processes slightly, it is done primarily to ensure that all safety measures taken for lifting objects are carried out, as well as providing an alternative solution that saves operating time.
For this project Sarens has deployed a team of experts consisting of a Safety Officer, five crane operators, five riggers, one cherry picker operator, one engineer and one supervisor. The main challenge they encountered is the crane movement on site on the steel mats after lifting the loads, as the area is widely spread.
First power generation for Dogger Bank C is expected in 2025, while the wind farm will be fully operational in 2026. The Dogger Bank C phase of the wind farm will have an estimated lifetime of around 35 years of clean energy generation.
Sarens owns an extensive international experience in the assembly and maintenance of wind farms. It is participating in installations in France such as Fécamp, Saint Nazaire, Provence Grand Large or more recently, in the lifting and transport work for the foundation bases of the new offshore wind farm in Saint Brieuc, off the Brittany coast, where it has been able to transport loads of more than 1,150 tons.
With regard to the transport and installation of electrical substations for offshore wind farms, Sarens also has proven experience, as it was responsible for the logistical manoeuvres required for the transport of a 2,922-ton substation in the port of Hoboken, in Antwerp (Belgium) to the Racebank wind farm, off Norfolk's coast.
